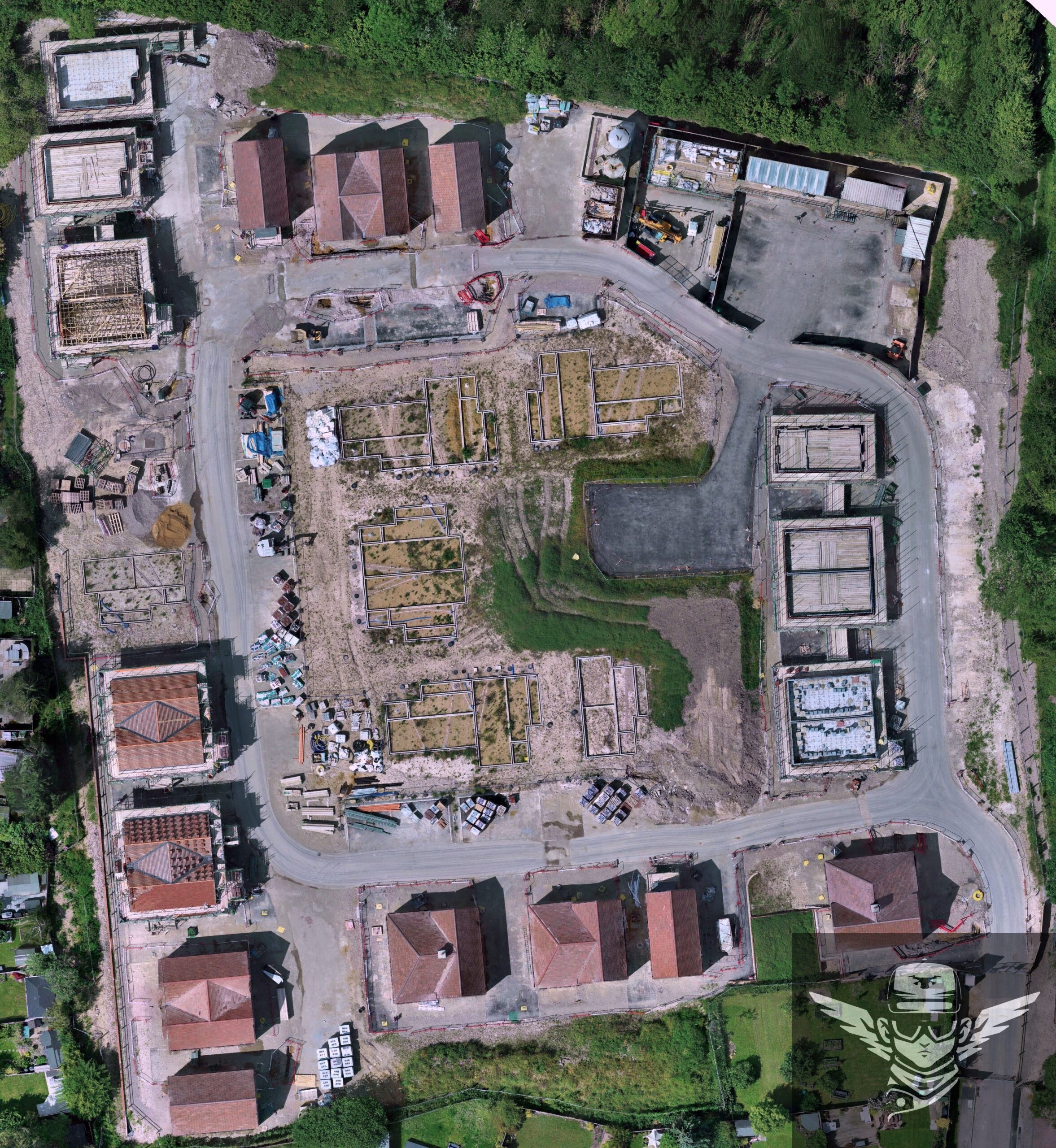

This orthomosaic, captured in Buckinghamshire on June 22, 2024, marks progress from our initial drone mapping on June 2.
Compared to the first image, key changes include:
- Increased site clearing: More uniform levelled ground, with reduced vegetation and debris.
- Additional concrete slabs: Several new foundation slabs poured, especially in the central and eastern sections.
- Initial framing and walls: Emerging structural frames and partial walls in multiple building footprints.
- New roofs on houses: In the bottom left area, several houses now have complete roofs added, advancing from bare frames to enclosed structures.
- Equipment and material build-up: More construction machinery (e.g., excavators) and material stacks (e.g., steel beams) visible, particularly near the northern boundary.
- Drainage and pathways: Preliminary drainage lines and access paths more defined, with gravel or compacted earth added.
